In April 2026, The Harvard Crimson reported on a university dining operation that moved into a kitchen trailer during a building renovation — and found the food got better. A senior chef told the paper the trailer "has more space and more stable equipment than we've ever had to work with." The same piece records what nearly derailed it: the unit ran at first on a single electrical breaker, so running several appliances together could overload the system and shut them down, and construction vibration kept tripping the gas off.
That is the whole subject in one story. A mobile kitchen is not automatically worse than the permanent kitchen it stands in for, and not automatically better. What decides it is the interior — how the line is laid out, what the equipment is rated for, and whether the power, water and ventilation behind it were sized for months of real service or for a weekend. This guide walks the inside of a unit system by system, and tells you what to look at before you sign.

What the Interior Has to Do
A purpose-built mobile kitchen interior is a complete commercial foodservice system in a towable envelope. It integrates cooking, refrigeration, warewashing, storage and sanitation to the same standards a health inspector applies to a permanent kitchen, under FDA Food Code requirements as your jurisdiction has adopted them.
The distinction that matters is not mobile versus permanent. It is purpose-built versus retrofitted. A retrofitted trailer starts as a cargo box and has equipment fitted afterwards, so the insulation, the electrical service and the ventilation were all specified for something other than the load they now carry. In a purpose-built unit the envelope and the kitchen inside it were engineered together. Where the two builds diverge is covered in our comparison of them, and why kitchen trailers fail covers what follows.
The Cooking Line and Cold Storage
The cooking line is arranged linearly, with prep positioned so ingredients reach the line without crossing a service path. In a narrow envelope that sequencing does more for throughput than total square footage does.

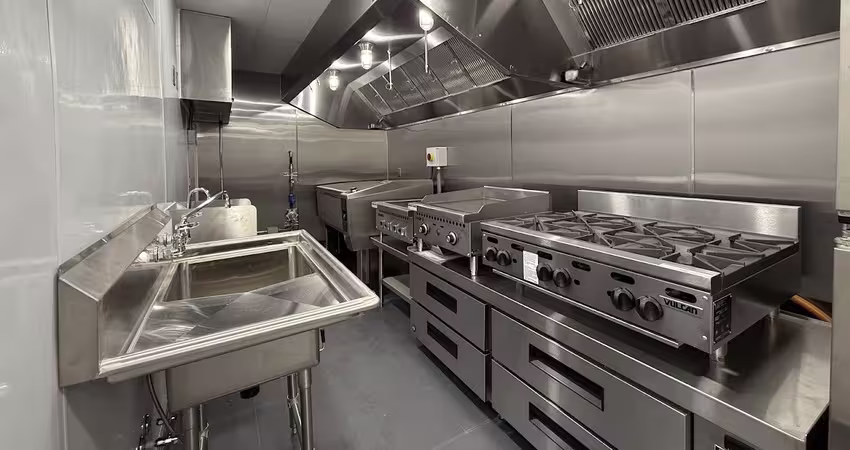

Standard configurations run convection ovens rated for continuous operation, gas ranges with heavy-duty grates, and fryers with high-recovery elements. Combi ovens appear often, because steam and convection in one cavity buys menu range without a second footprint. What separates a unit you can work in for five months from one you can't is the duty rating rather than the appliance list: equipment specified for intermittent use behaves differently under a full service every day, and the difference surfaces as inconsistent output and mid-service failures, not as anything you could have read off a spec sheet.
Ask who certified each piece, and to what. An NSF mark is third-party verification against sanitation and durability criteria, which is a different thing from a manufacturer's own specification. Our essential equipment list works through the full schedule.
Cold storage follows the same logic. Reach-ins carry bulk, undercounter units sit on the line, refrigerated prep tables do both, and larger footprints carry walk-in cooler and freezer space instead. The question worth asking is how the refrigeration holds temperature when the outside ambient is at its worst, because a trailer skin has far less thermal mass than a masonry kitchen.
Tip: Get the temperature-logging arrangement in writing. Digital logging is what you hand an inspector; a clipboard is what you explain to one.

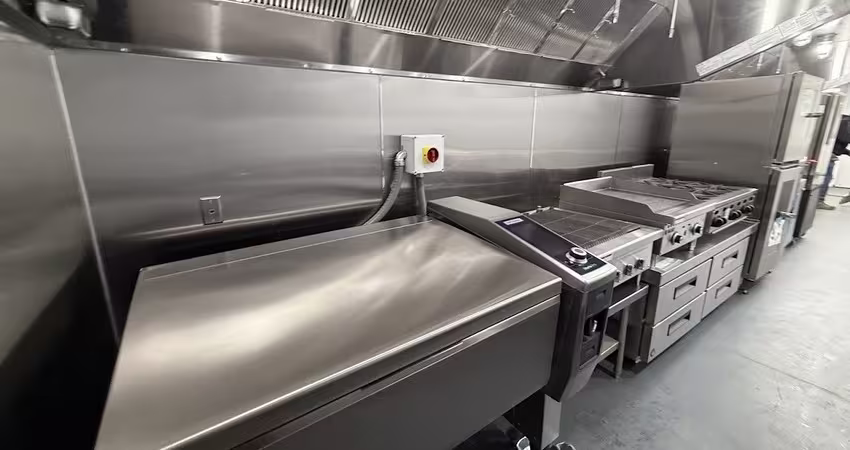

Ventilation, Makeup Air and Fire Suppression
Ventilation decides whether staff can work in the unit, and it is what retrofits most often get wrong. Type I hoods capture grease-laden vapour over the line, filters strip it, fire-rated ductwork carries it out. Extracting that air pulls the room negative unless it is replaced, which is the makeup air unit's job — without one the hood underperforms and the room draws hot air from wherever it can.
The governing documents are NFPA 96 and ANSI/ASHRAE Standard 154. Suppression is a wet chemical system to UL 300: nozzles over every cooking surface, a manual pull station, fuel shutoff tied to the exhaust fan controls. Our fire safety and suppression guide covers the inspection cycle, and the gas versus propane comparison covers what changes with the fuel.
Note: Air conditioning is a separate item from makeup air, and both belong in the specification. A unit with a compliant hood and no cooling is compliant and unworkable in August.
Power: the Constraint That Sets Everything Else
The Harvard case is the argument for reading this section first. Electrical capacity is the single most common reason a mobile kitchen underperforms, because every other system depends on it and the shortfall only appears under simultaneous load — which is to say, during service.
Units run on properly sized service panels with circuit protection, the service and amperage driven by the equipment schedule and the refrigeration duty. Connection is either shore power or a generator. The number to establish before delivery is not the running load but the starting load, because compressors and motors draw a multiple of their rated amperage on start-up, and a panel sized to the running figure will trip when the walk-in cycles mid-service.
Get a written load schedule listing every appliance. Our electrical planning guide explains how to read one against your site's capacity, generator sizing covers the off-grid case, and the distribution panel guide covers what sits behind the door.

Water, Waste and Warewashing

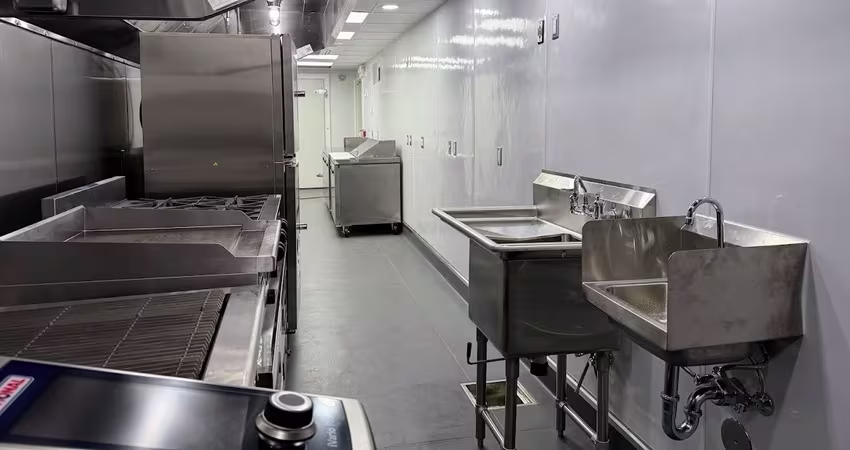

Warewashing is built around a three-compartment sink sized for commercial cookware — wash, rinse, sanitize — with its dimensions and the separate handwash station set by code rather than preference. Three-compartment sink requirements sets out what an inspector will measure.
Water arrives from a mains connection or from tanks, with demand pumps and a heater sized to the service. Greywater collects in tanks at or above the freshwater capacity, serviceable from outside without interrupting the line. On tank supply, service intervals become a scheduling item — mobile kitchen water supply works through flow rates and hookups.
Grease is its own question, and usually the client's: the trap sits on the waste side and sizing it is site-specific. Our grease trap guide covers types and care.
Workspace, Storage and What Survives the Road
Stainless prep tables give the working surface, overhead shelving takes the vertical space, and fold-down surfaces extend the line at peak then stow for transport. Dry storage sits in cabinets; chemicals sit separately, ventilated, away from food.
Everything latches. A fixture that works in place and shakes loose in transit arrives broken, and joinery in a unit built for repeated deployment is specified for road vibration in a way a converted box's rarely is.
How the Interior Changes With Footprint
Configuration follows size. The four Mobile Culinaire footprints and what each supports:
| Footprint | Interior area | Meals per day | What the interior adds |
|---|---|---|---|
| 32′ | 256 sq ft | 150–200 | Single three-compartment sink; reach-in refrigeration and freezer |
| 40′ | 320 sq ft | 200–250 | Adds a makeup-air unit |
| 53′ | 450 sq ft | 300–450 | Worktop and sandwich-prep refrigeration; two- and three-compartment sinks |
| 2×53′ | 900 sq ft | 500–650 | Two trailers joined by an interior door; conveyor dishwasher with clean and soiled dishtables |
The equipment schedule within each footprint is configurable against available inventory, so the table is the baseline rather than a fixed package. Size against your peak service day, not your average one.

What We Build Into Every Unit
Mobile Culinaire designs, engineers and manufactures in-house in Oregon, building up from manufactured kitchen modules rather than converting a freight box, with more than 400 units delivered. We are an approved modular manufacturer in multiple states and deploy across the USA.

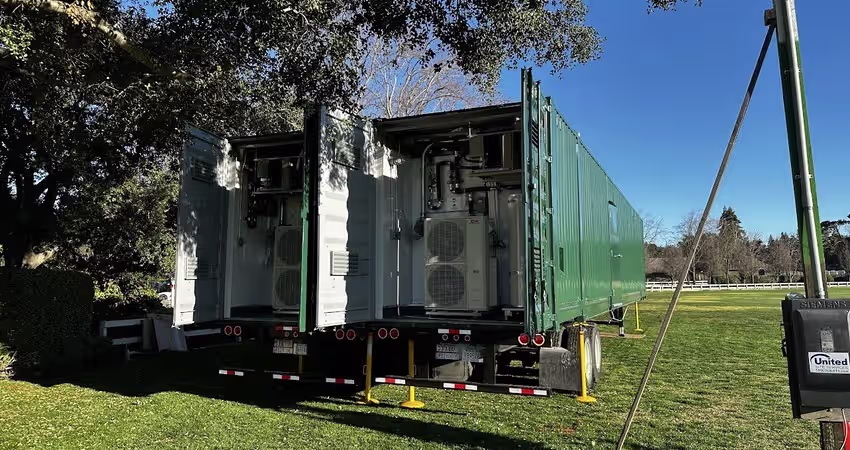

What that means for a specification: envelope, MEP and kitchen are designed as one system, units are third-party inspected before they leave, and technical documentation and installation guides come with them. Menlo Circus Club, a private country and polo club in California, ran a full menu from a 2×53′ unit — burner range, fryers, double-deck oven, walk-in cooler and freezer, dry storage — through five months of renovation at 400 to 500 meals a day, connected to a grease trap and compliant with California code.
From first conversation to first service is six to fifteen weeks. Scoping and design account for four to eight of those, permitting for one to six, and installation for about a week. Permitting is the stage that moves, because it belongs to your jurisdiction rather than to us. The delivery and setup process covers that final week.

How to Judge an Interior Before You Sign
Six things to establish while the specification is still a draft:
- The load schedule. Every appliance, running and starting amperage, against your site's available service.
- Makeup air and cooling, separately. Confirm both are in the unit, not just the hood.
- Duty ratings, not model names. What is the equipment certified to, and by whom.
- Refrigeration under your ambient. How it holds at your site's worst temperature, not at 70°F.
- Water and waste intervals. Tank capacities, service frequency, and who is arranging it.
- What is yours versus ours. The client supplies and connects power, water and gas, the waste route and grease trap, any decks or ramps, and owns the permit — health and safety compliance and code and permit requirements cover what each authority asks for.
Get those six answered and the interior will hold up for the length of the project. Leave them to delivery week and you inherit the Harvard problem: a good kitchen on a breaker that cannot carry it.
Disclaimer
Codes differ between jurisdictions, and the edition yours has adopted is the one that governs. Confirm ventilation, suppression, plumbing and electrical requirements with the authorities having jurisdiction before dates are fixed. The permit belongs to the client.
People Also Ask
What cooking equipment comes in a mobile kitchen trailer?
Convection ovens, gas ranges, griddles, fryers and steamers, with combi ovens common where menu range matters more than a dedicated footprint. Refrigeration runs from reach-ins on smaller units to walk-in cooler and freezer space on larger ones, alongside prep areas, a three-compartment sink and a handwash station. The schedule is configured against your menu and volume rather than supplied as a fixed package — the essential equipment list breaks it down.
How is ventilation handled inside a mobile kitchen?
Through a Type I hood with grease filters and fire-rated ductwork, a makeup air unit replacing what the hood extracts, and a UL 300 wet chemical suppression system over the cooking surfaces. NFPA 96 and ASHRAE 154 govern, and cooling is specified separately from makeup air. A hood without makeup air underperforms and leaves the room hot.
What decides whether staff can work in one for months?
Three things, in order: electrical capacity under simultaneous load, makeup air and cooling, and whether the layout keeps prep off the service path. Duty ratings matter after those. Our staff training playbook covers the operational side of a long deployment.
Bringing It Together
The interior is the product. What a mobile kitchen can and cannot do across a five-month renovation is set by how it was built and what it was specified to carry — which is why these questions belong in the drawing stage, not in delivery week.
If you are scoping a renovation, an expansion or a capacity gap, tell us what you need to keep serving and we will specify an interior against it. That specification is cheapest to get right before anything is ordered.
